Historic Project Aims to End the Energy Isolation of the North and Reduce Dependence on Polluting Sources
With over 70% of the work completed, the construction of the Tucuruí Power Line is set to connect Roraima to the National Interconnected System (SIN), solving decades of blackouts and instability in energy supply. The structure, spanning over 1,800 km, crosses the Amazon and will definitively link the far north of Brazil to the national electrical grid.
The Importance of Construction for Energy Security in the North
Roraima is currently the only Brazilian state outside the national electrical system. Since 2019, it has depended solely on diesel-powered thermoelectric plants, a costly and highly polluting alternative. The construction of the Tucuruí Power Line emerges as a definitive solution to provide clean, stable, and economical energy to the region. According to Transnorte Energia, the work is expected to be completed by September 2025, with full energization by December of the same year.
Construction Involves Complex Engineering and Innovative Logistical Solutions

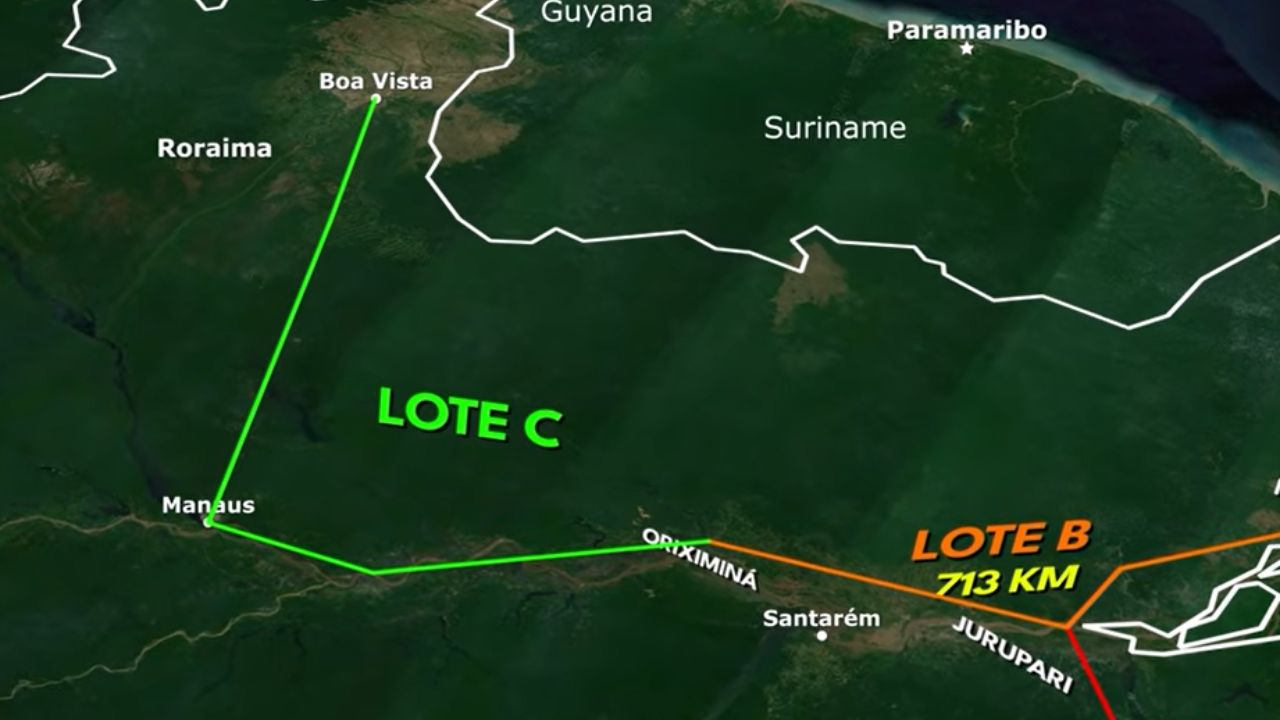

The project includes seven double-circuit transmission lines, totaling about 1,800 km in length and supported by over 3,600 metal towers. One of the biggest challenges was crossing the Amazon River, with spans exceeding two kilometers. In areas of dense forest, helicopters were necessary for transporting parts and manually constructing trails. More than 30,000 tons of galvanized steel were used, according to data from the Urbana channel.
-
Buried house on Greek island uses stone, concrete, wood, and glass to appear as part of the rock, according to MOLD Architects, while movable facades, internal courtyards, and pergolas bring air, shade, and light to the spaces hidden in the hillside.
-
Concrete thrown away can turn into money on the construction site itself and sell aggregate by the ton, according to a technical survey on mobile crushing that transforms debris into business for construction companies attentive to heavy costs.
-
The 980-meter, R$ 329 million bridge began receiving concrete in its foundations this week, with blocks 3.5 meters deep that consume the equivalent load of 57 concrete mixer trucks each, and the structure of the Joinville bridge will have a 160-meter span over the Cachoeira River without any pillar in the middle.
-
Couple buys a century-old ruin in the French countryside for around $170,000, leaves their life in Paris behind, and spends four years renovating almost everything with their own hands, amidst costly mistakes, international volunteers, and a new way of living.
Environmental, Social Impact, and Connectivity
In addition to providing energy, the Power Line brings connectivity: alongside the high-voltage cables, fiber optic cables were installed, allowing high-speed internet for isolated regions. The project was accompanied by strict environmental licensing and negotiations with indigenous communities, such as the Yanomami and Waimiri-Atroari, respecting traditional territory and legal requirements.
Energy and Economic Transformation for Roraima
The expectation is that the completion of the Power Line will transform the energy landscape of Roraima, which currently relies on over 1 million liters of diesel per day. Integration into the SIN will reduce costs, lessen environmental impacts, and boost economic and social development. For millions of Brazilians in the North, the construction of the Power Line represents more than an engineering project — it symbolizes dignity, security, and the future.
