Duplication of BR 262 in ES Will Cost 15 Times More Than the Mestre Álvaro Bypass. Understand the Value of This Project and the Importance of the Tunnel on BR-262 in Espírito Santo.
The duplication of BR 262 in ES is expected to cost the equivalent of building more than 15 Mestre Álvaro bypasses, a project that challenged engineering in the state and took over four years to complete. The estimate is that the tunnel on BR-262 Espírito Santo, designed to improve traffic flow on the highway connecting the Espirito Santo territory to Minas Gerais, will be presented to cities soon.
Project Will Cost 15 Times More Than Works of the Mestre Álvaro Bypass
The cost of duplicating BR 262 in ES is part of studies conducted at the request of the National Department of Transport Infrastructure (Dnit). According to the Dnit, there is still no final budget defined for the tunnel on BR-262 Espírito Santo, nor a schedule for execution, due to the complexity of the project, especially regarding geotechnical and topographical challenges.
However, based on indirect estimation methodologies and the use of average management costs, the estimate is that the investments needed for the total execution of the Duplication of BR 262 in ES will be around R$ 8 billion, 15 times the value of the Mestre Álvaro bypass.
-
Pressured by people living in street encampments, the city created modular communities of intermediate housing totaling 243 spots, private rooms, and support services to remove residents from the sidewalk before the arrival of a permanent home in Santa Barbara County, California.
-
Amazon site sells a house for 10,000 euros, around 60,000 reais, with up to 4 bedrooms, fully furnished interior, and assembly in just 10 minutes; steel model with thermal insulation promises to challenge the high costs of traditional construction in Spain.
-
China participates in a megacomplex in the Andes with 2,000 beds for workers of a billion-dollar copper project.
-
The John Deere forestry truck carries 19 tons of wood per trip, uses traction power to overcome mud, slopes, and narrow trails, and becomes the hidden link between the felled tree and the pulp industry.

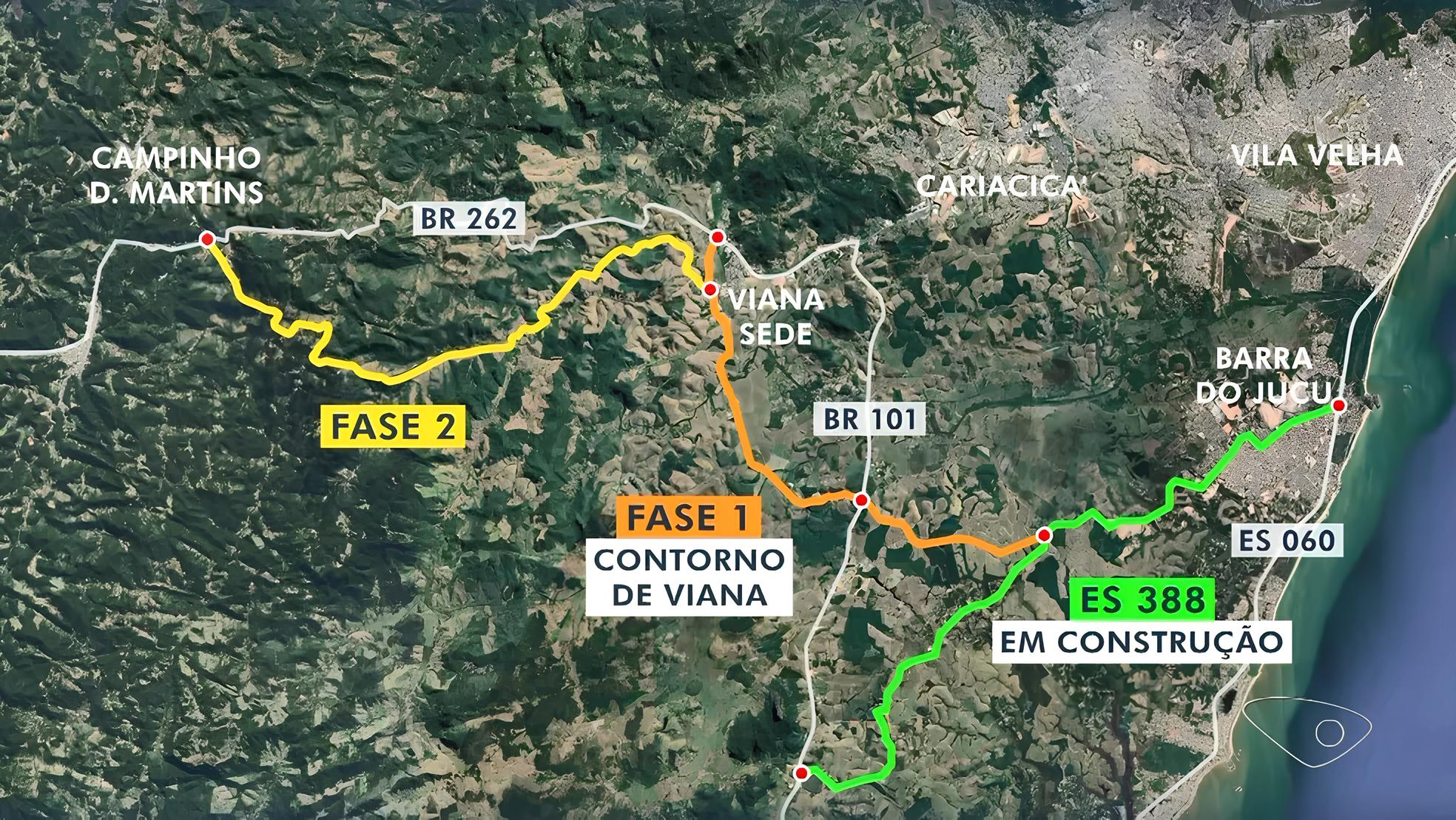

This amount will be invested in the duplication of BR 262 in ES from the intersection with BR 101, in Viana, in the Metropolitan Region, to Iúna, at the border with Minas Gerais, totaling 180 km in length.
Learn More About the Mestre Álvaro Bypass
Inaugurated in December 2023 in Serra, the project known for challenging engineering in the state features pillars with a height similar to a 16-story building anchored in soft and marshy soil, has an extension of 19.7 km, and cost R$ 476 million.
While each kilometer of the Mestre Álvaro bypass cost an average of R$ 24 million, the Tunnel on BR-262 Espírito Santo will cost R$ 50 million, demonstrating the complexity of the construction.
It is important to remember that in October 2024, the state government announced that it would allocate R$ 2.3 billion from the Mariana agreement to fund part of the construction on BR 262. This amount is expected to be used to finance the section between Viana and Venda Nova do Imigrante, in the Mountain Region, which has the most complex geography along the entire length of the highway.
According to Dnit, the segment corresponds to phase 1 of the project, which should be presented to cities in March. The project for the Duplication of BR 262 in ES began to be developed after the contract signed on July 7, 2023, with the Pedra Azul Consortium, responsible for environmental licensing and construction.
Understand the Importance of the Tunnel on BR-262 Espírito Santo
Sergio Vidigal (PDT), the current secretary of the department following the departure of Vice-Governor Ricardo Ferraço (MDB), has been in charge of the State Secretariat for Development (Sedes) for a month and stated that, according to Dnit data, BR 262 should have a large part duplicated and, in the sections with more complicated geography, will feature a new route parallel to the current one.
According to Vidigal, the Duplication of BR 262 in ES is a highly necessary project for the state’s logistics sector, as it would be the way to connect more quickly to Minas Gerais. Since ES has a large port infrastructure, it is essential to have not only railways and airports but also well-structured highways to transport all production.
