Japanese Engineers Performed The Most Complex Rock Removal In The World On The Joshinetsu Highway In Gunma, Building A 70-Meter High Scaffold To Disassemble A Mass Of Millennial Andesite Directly Over An Active Expressway Without Dropping A Single Stone.
The Joshinetsu Highway, which connects Kanto to Nagano and Niigata, has become the stage for one of the greatest feats of modern civil engineering. An immense metal structure was erected to allow for the removal of rock 70 meters high and 80 meters wide, located above the roadway, without interrupting traffic and without any debris falling. The operation, conducted by Obayashi Corporation, took a decade of preparation, simulations, and execution, redefining global safety and precision standards.
The project was motivated by a tragedy that occurred in 1996, when a landslide in Hokkaido killed 20 people by collapsing the Toyohama Tunnel. Since then, Japan has systematically reviewed slopes near highways and tunnels. In Gunma, inspections revealed the risk of a landslide from a gigantic block formed about five million years ago. The response was an unprecedented operation that combined cutting-edge technology, millimeter logistics, and a total commitment to safety.
Vertical Engineering Under The Risk Of Gravity

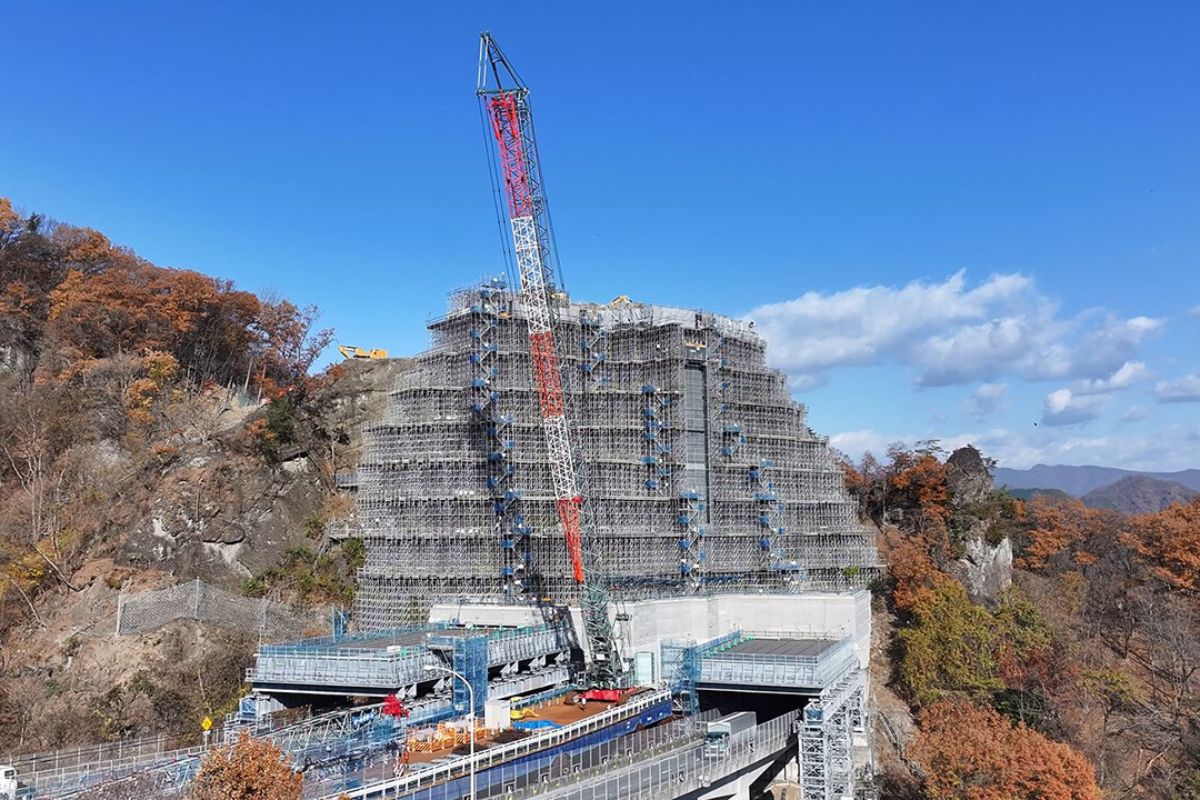

The first stage involved the construction of a 70-meter scaffold, equivalent to a 23-story building, covering the entire slope above the highway.
-
Fishermen find a rare 127 kg substance inside a whale in Yemen, sell the “whale vomit” for $1.5 million, and become millionaires with the find in the Gulf of Aden.
-
The paycheck that seemed impossible: São José employee receives R$ 7.94 after legal strike, while deductions by the City Hall affect over a thousand employees and become a target of inquiry in the City Council.
-
With only R$ 50 in his pocket and a dream, the 26-year-old Tocantins native Willian Gomes left Tocantins and has already cycled over 4,000 kilometers towards Ushuaia, at the southern tip of Argentina, without accepting a single ride in eight months.
-
Pink lagoon of Torrevieja appears in NASA image as if it were an artificial structure, but impresses scientists by hiding a natural process formed by salt and microscopic life.
This structure functioned as a technical fortress, allowing engineers to access every point of the rock without interrupting the intense flow of vehicles below.
A two-meter-thick cushioning layer was installed over the pavement to contain any potential fragments, although the goal was clear from the beginning: not to drop a single stone.
The project was calculated through dozens of simulations, totaling 85 computational models to predict the behaviors of the rock mass during fragmentation.
Each stage of rock removal required precise planning, as the scaffold, cranes, and access tracks needed to withstand the simultaneous weight of trucks and excavators up to 80 tons.
Diamond Tools And Controlled Dismantling
Due to its location over an active road, demolition with explosives was discarded.
The type of rock, andesite, is extremely hard and compression-resistant, which required special drills with diamond tips for drilling and subsequent manual fragmentation with hydraulic crushers.
The process was carried out from the inside out, avoiding fragments being thrown toward the road.
The edges were removed in stages, utilizing a method of angled impact that caused the rock to fall inward into the slope rather than outward.
This millimeter control of energy was essential to ensure stability and safety throughout the work.
Continuous Operation And Precision Logistics
The work progressed 24 hours a day for years, requiring synchronization between human teams and heavy machinery.
Temporary tracks and a vertical monorail were installed on the slope to transport equipment to the top, enabling daily access to the risk area.
Each advance was monitored by sensors and drones, ensuring the integrity of both the scaffold and the roadway below.
The operation involved hundreds of specialized professionals and established Japan as a global reference in high-complexity rock removal.
The project manager, Takuma Ohga, stated that the goal was twofold: to completely remove the unstable mass and, at the same time, to demonstrate that engineering and safety can coexist even in the most adverse conditions.
Technical Legacy And Public Inspiration
After ten years, the project was successfully completed, and the details were opened to the public in guided tours that received seventy times more registrations than anticipated.
The public interest reflected the impact of the project, viewed as a symbol of perseverance and technical precision.
Participants of the tours highlighted the discipline and attention to safety as inspiring examples of Japanese engineering.
In addition to eliminating a critical geological risk, the project established new construction standards in mountainous areas, showing that it is possible to operate with high technical complexity without compromising mobility.
The rock removal on the Joshinetsu Highway has become a global landmark of engineering applied to disaster prevention.
