Integration Bridge Works Brazil – Paraguay Started Last Year, Generating Over 2500 Jobs and Expected to Be Completed by Mid-2022.
The construction of the International Integration Bridge, funded by the Itaipu Hydroelectric Plant, which will connect Foz do Iguaçu, Brazil, and Presidente Franco, Paraguay, is 49% complete and guarantees over 2500 jobs in the region. The expectation is that by the end of December, fifty percent of the project will be completed.
Also Read
- Ethanol Prices Drop at Mills
- Multinational Sodexo Offers Job Openings for Elementary, Technical, and Higher Education Levels in Rio de Janeiro, São Paulo, Macaé, and More, This 27th
- Andrade Gutierrez Has Job Openings in Civil Construction Projects for Engineers, Supervisors, Coordinators, Managers, and Analysts
- Nissan Is the Seventh Automaker to Halt Vehicle Production and the Automotive Industry Might Collapse in Brazil
Considered one of the most important structural works for the region and, consequently, for all of Mercosur, the bridge connecting Brazil and Paraguay began construction before the COVID-19 pandemic crisis and survived the period – the most severe in recent times from an economic perspective as well. Throughout 2020, it has directly employed 452 people on both banks of the Paraná River, in Brazil and Paraguay.
Once completed, the second bridge between the two countries will provide another stimulus for regional development, facilitating freight logistics and improving traffic in central Foz do Iguaçu and on the Friendship Bridge.
-
Man builds house with concrete made from recycled paper and attracts attention in Portugal; named Porta do Caracol, the home features solar panels, a vertical garden, and a pool with natural filters.
-
Goodbye to conventional plaster? New material used on walls reduces waste and steps in construction and draws the attention of engineers by offering faster application and greater construction efficiency – discover the advantages of smooth gypsum.
-
Norway will excavate 3 million cubic meters of rock to open a 1,700-meter maritime tunnel, where ships will pass through a mountain in 10 minutes, escaping a stretch that has killed more than 30 people since 1900.
-
How much does it cost to build a sidewalk with interlocking pavement in 2026? See the average construction prices and the most common extra expenses that can increase the final budget.
These Works Are Guaranteeing Over 2500 Jobs
These and other structural works funded by the Brazilian margin of the Itaipu plant, with investments of over R$ 2.5 billion in two years of management under General Joaquim Silva and Luna at the Brazilian General Directorate, were only made possible through a restructuring of the company. These projects are ensuring job positions for over 2,500 people.

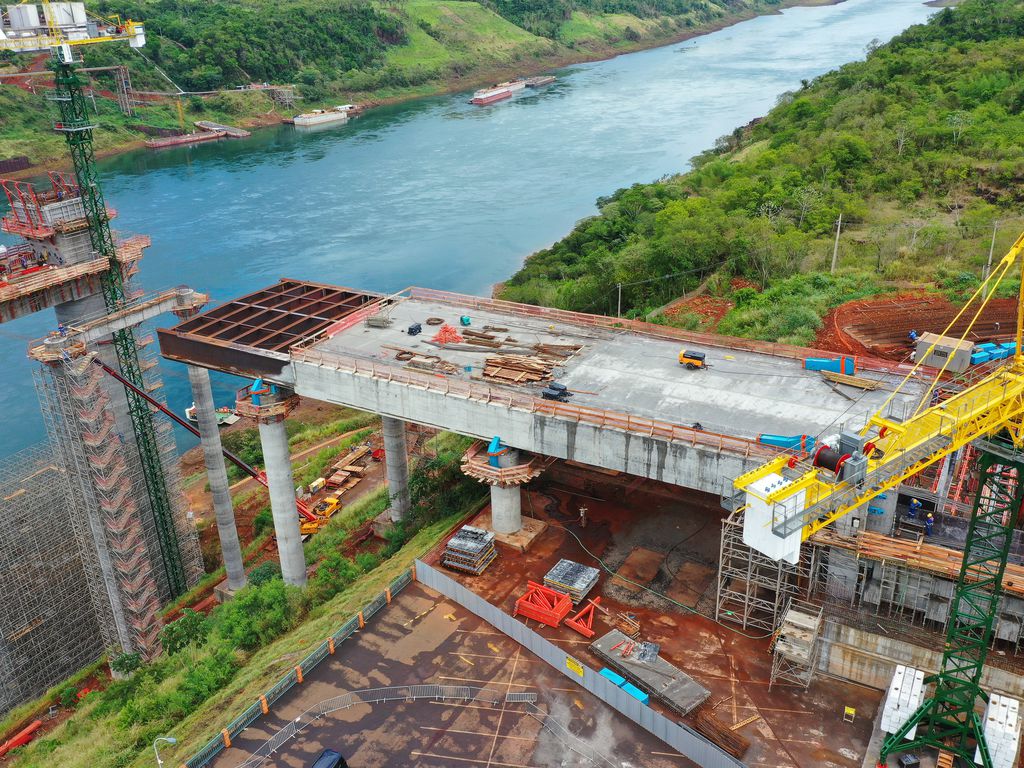

According to the DER, with the completion of the displacement process of the concrete sections on the Brazilian side, in March, the execution of the second stage of the equilibrium box began, which is 22.70 meters wide and 25 meters long, made of reinforced concrete, serving as a counterweight for the central span of the bridge.

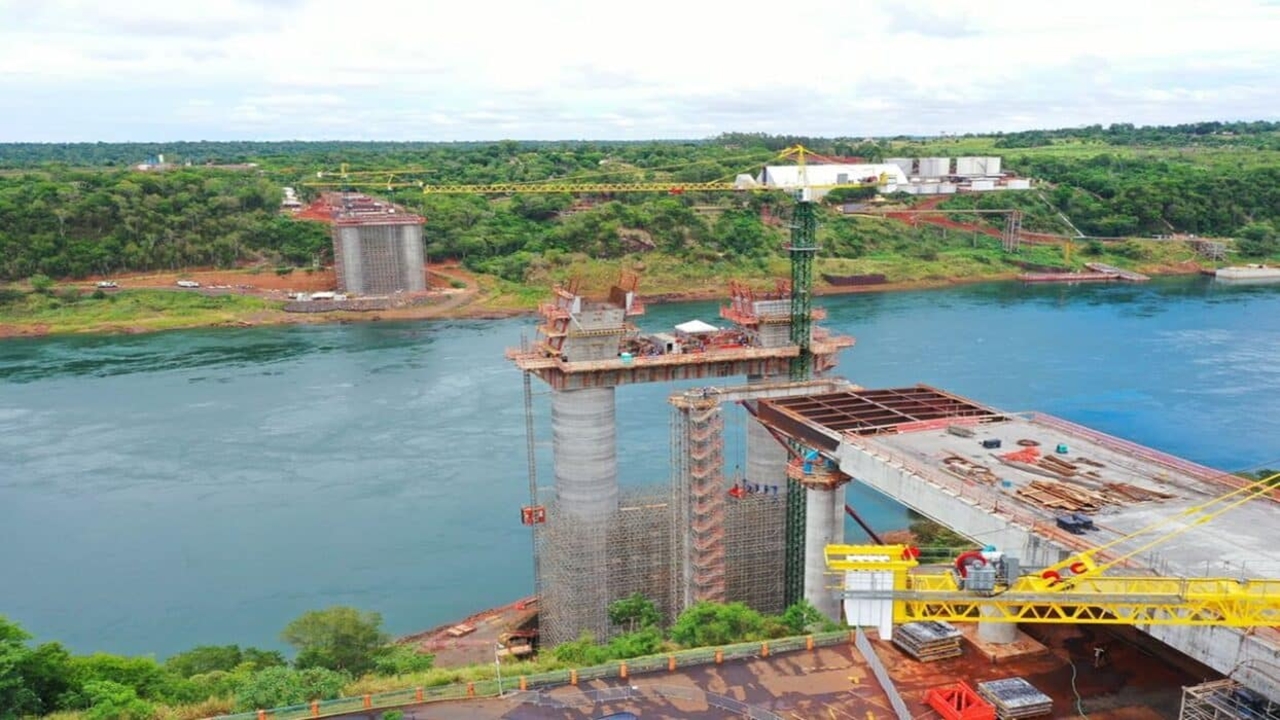

In this phase, the installation of the 18 form tube units, out of a total of 160, which will house the bridge’s stay cables, is being carried out. The execution of the Brazilian mast at support 06 continues at an accelerated pace, potentially reaching a total height of approximately 118 meters by the end of the month.
Stage of Works in Paraguay
In Paraguay, the stage of works is also advancing. The execution of the mast has progressed rapidly. The forecast is that by the end of the month, approximately 88 meters of height will be completed. At support 01, work has continued on the execution of the second concrete section and its displacement. This second section is 20.50 meters wide and 28.12 meters long, made of reinforced concrete with an approximate weight of 1,100 tons.
As for the accesses, the department reports that, so far, 2% of the works have been executed. Investments total R$ 2.3 million.
