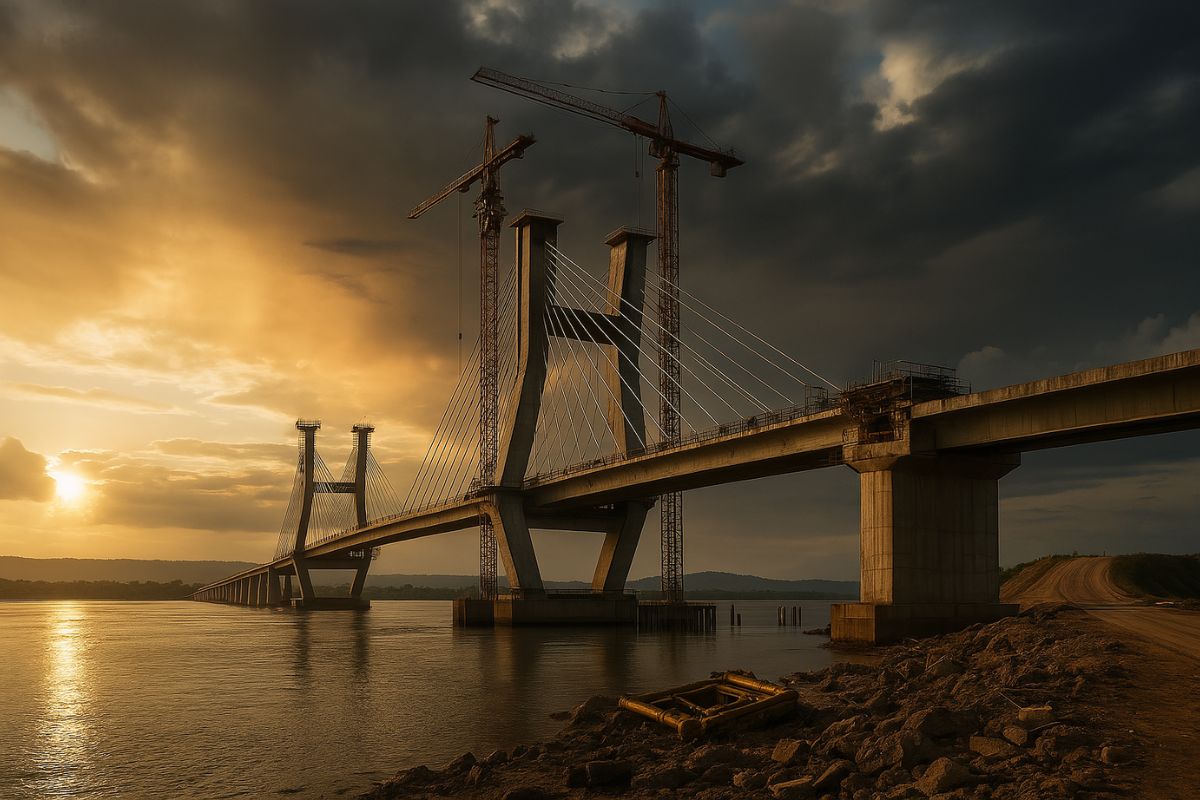

The Xambioá Bridge, A Strategic Project of BR-153, Is 95% Completed, But There Is No Real Forecast for Use. The Population Continues to Depend on Ferries to Cross the Araguaia River.
The Xambioá Bridge, which was supposed to be a game-changer in the infrastructure between Tocantins and Pará, is technically ready. With a length of 1,728 meters over the Araguaia River and costs that have already exceeded R$ 233 million, the project has reached 95% completion but remains inaccessible. In the meantime, drivers and residents continue to cross by ferry, incurring high costs and long waits.
Promised for September 2022, the delivery has been delayed several times. Now, according to the National Department of Transport Infrastructure (DNIT), the new forecast is the second half of 2025. The reason? The bridge is standing, but the accesses do not yet exist.
Xambioá Bridge and the Crossing That Never Arrives
The structure connects Xambioá (TO) to São Geraldo do Araguaia (PA) and integrates BR-153, a crucial route for agribusiness and cargo transport from North to South Brazil. The highway also serves as an outlet for production from the Matopiba region (Maranhão, Tocantins, Piauí, and Bahia), which is growing rapidly.
-
More than a decade of delays: the duplication of Lot 1 of BR-280, between São Francisco do Sul and Jaraguá do Sul, had its project approved in 2013, suffered stoppages and has remained halted since 2022, with only 36% of the services completed.
-
The world’s largest ghost stadium is now entering an unprecedented phase after 15 years abandoned and is expected to host games of the 2030 World Cup.
-
In Niger, mud buildings have stood for ten generations while the world spends billions on concrete and steel, now African architects are proving at the Venice Biennale and in real projects that red earth can be the smartest and most sustainable building material of the 21st century.
-
Before building your single-story house, check out 5 floor plan mistakes that seem small but can ruin your family’s circulation, privacy, and comfort.
But in practice, nothing flows. Truck drivers continue to pay up to R$ 294 for crossing via ferry, with delays approaching an hour. Residents spend R$ 25 per vehicle, R$ 5.50 per bicycle, and face the daily struggle to study, work, or access health services on the other side of the river.
“It’s a wait of 30 to 45 minutes, depending on the river level. This impacts the entire regional economy,” says the mayor of Xambioá, Mike Câmara.
A Modern Bridge Stalled by Old Mistakes
The Xambioá Bridge was built with cutting-edge engineering: successive cantilevering, high-performance concrete, corrosion-resistant steel, and pillars driven dozens of meters below the riverbed. All to ensure stability, durability, and heavy vehicle traffic.
However, one detail was missing: the accesses. The stretch on the Pará side will be 310 meters. On the Tocantins side, 1,700 meters. None of them have started construction. Paving, signage, lighting, and the transition slab have also not been executed. Everything depends on new bids, approvals, and, above all, land compensation.
According to the Xambioá city hall, many residents have not yet received the compensation amounts. In the meantime, the completed bridge remains a mirage.
Brazil That Delays Its Own Progress
The Xambioá Bridge is a clear example of a chronic vice in Brazilian public works: lack of planning. Data from the Federal Court of Accounts show that the country has more than 14,000 unfinished projects.
“Expropriation should be the first step of any public work. They started with the bridge and forgot about the accesses. A primary error that created a gigantic impasse,” criticizes Marcelo Daniel Melo, president of the Brazilian Institute of Evaluations and Expertise in Engineering.
Now, the promise is that the complementary services will extend until July 2025. Until then, the R$ 233 million bridge continues to serve only as a postcard. A monumental structure, isolated by tiny decisions.
